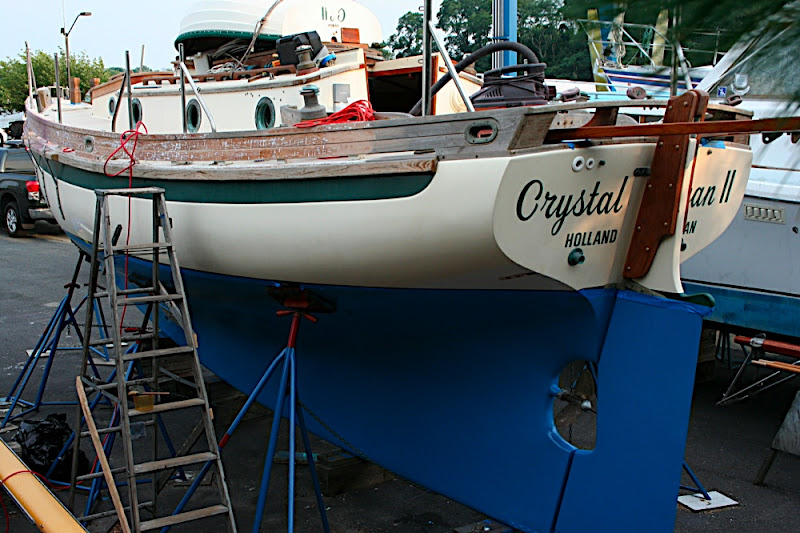

Although I don’t think I’ll meet my August 7th launch ‘deadline’, I’m putting in long days and keeping up the momentum in hopes of being damn close…
The Rig

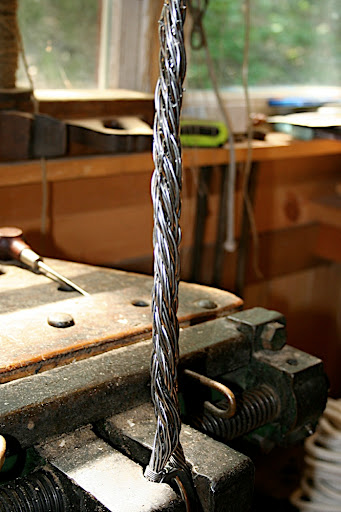

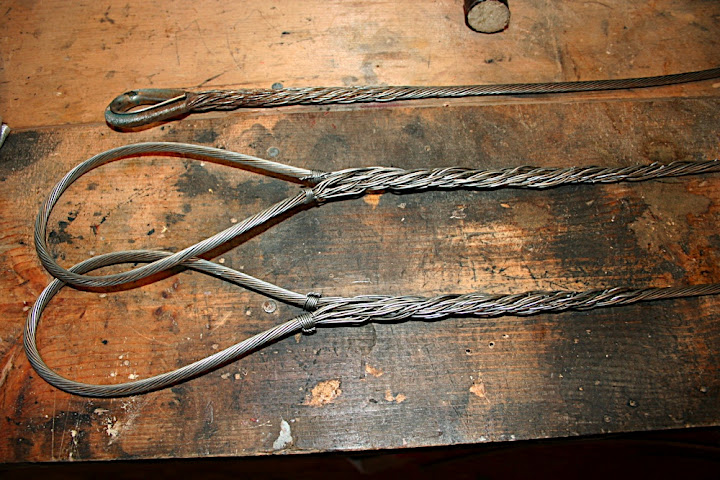

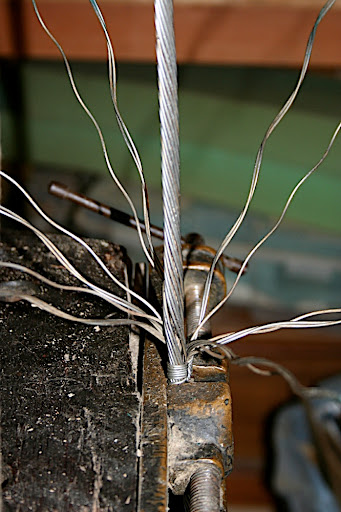

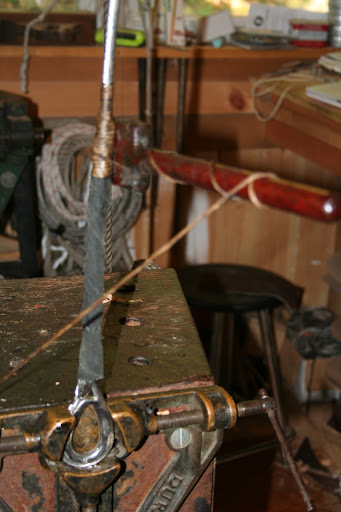

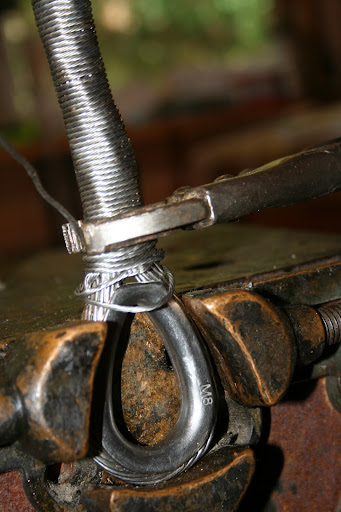

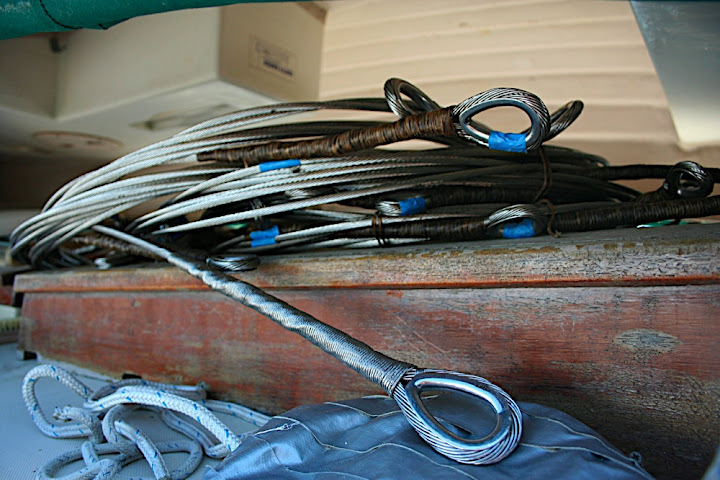

The Rig is finished, all served up in marlin and a few in wire. I learned from Jeff at Rigging Only and Brion Toss via his forums, that I should have served the wire where it bends around the thimble to prevent the strands from loosening and getting out of position… oh well too late. Serving took me about 10 hrs, roughly 30 minutes each, with set up etc. Both Brion and Jeff agreed that serving isn’t going to promote corrosion to the degree that would cause alarm. I’m going to guess I spent a total of about 70 hrs on the rig. It took a long time. With the additional expenses of a marlin, thimbles, some new toggle jaws, paying Myles for his time, I think my overall cost of the rig is about $2,000. I will do a detailed expense analysis soon… I’m scared.

Time Wasted…

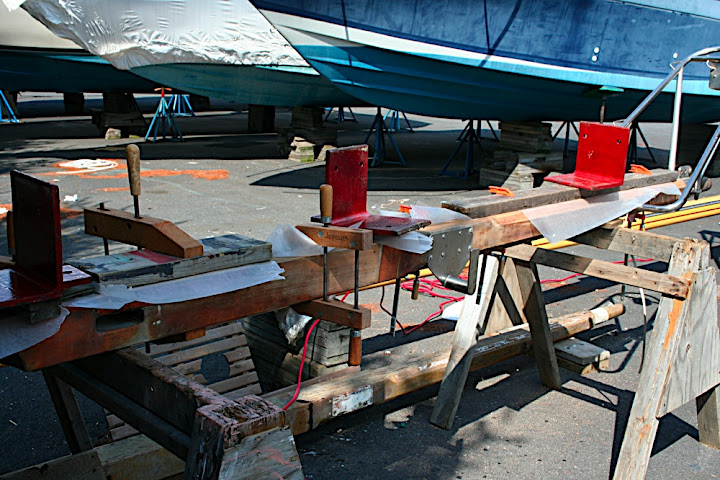

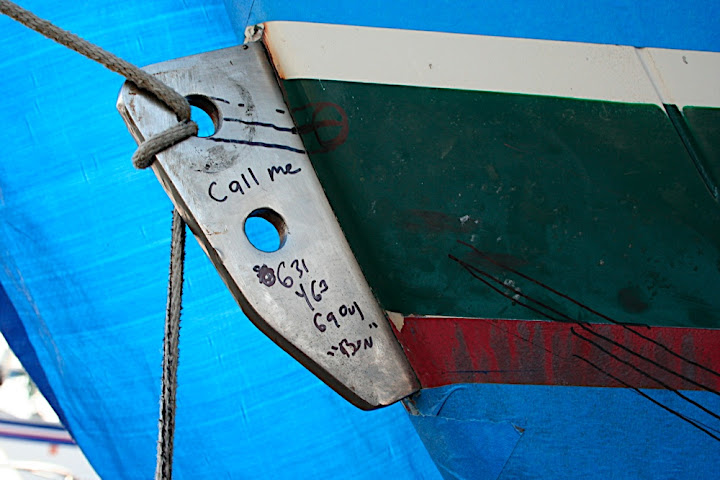

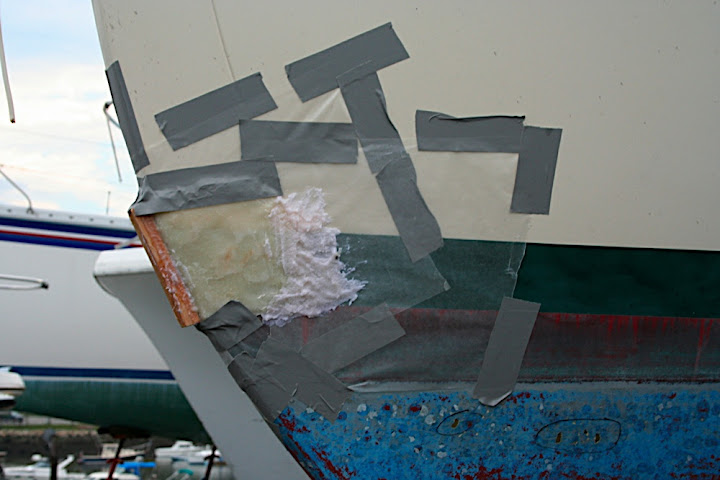

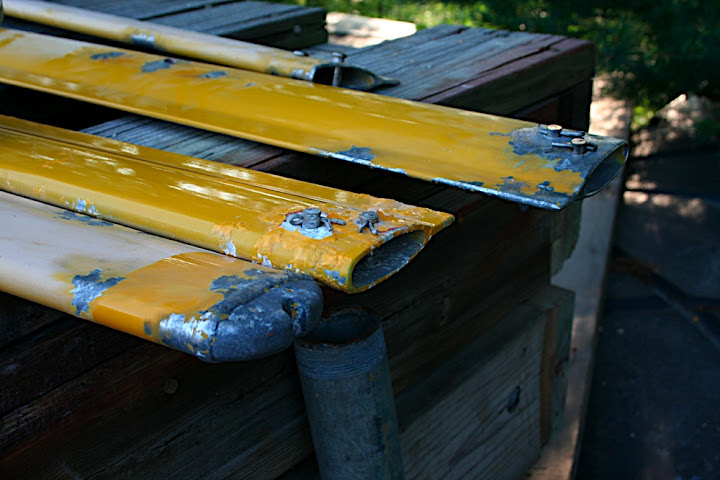

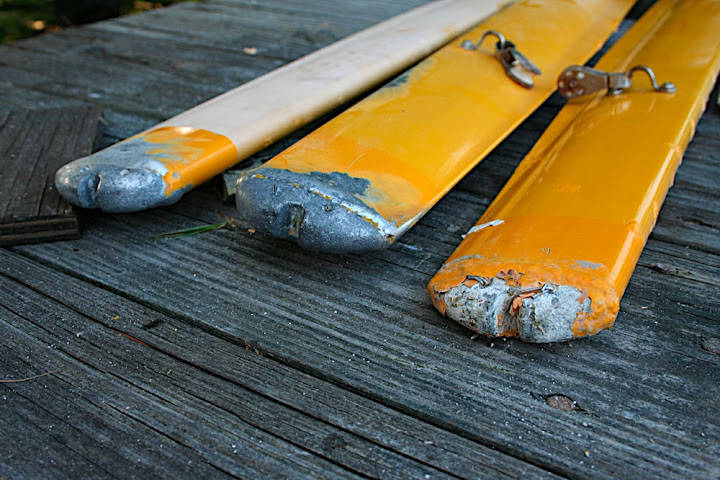

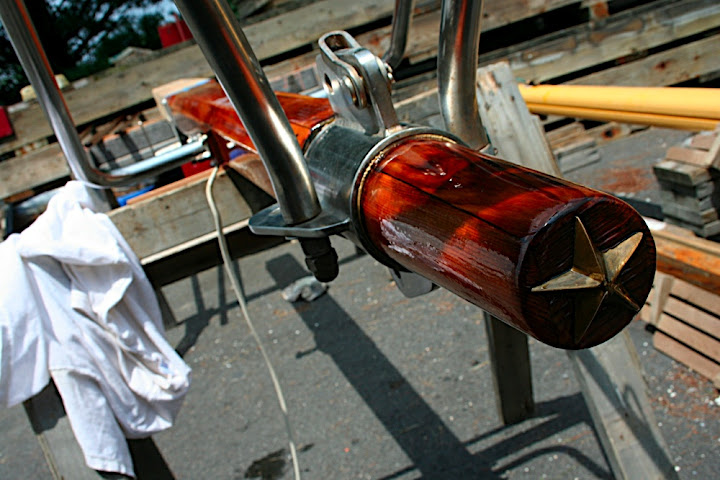

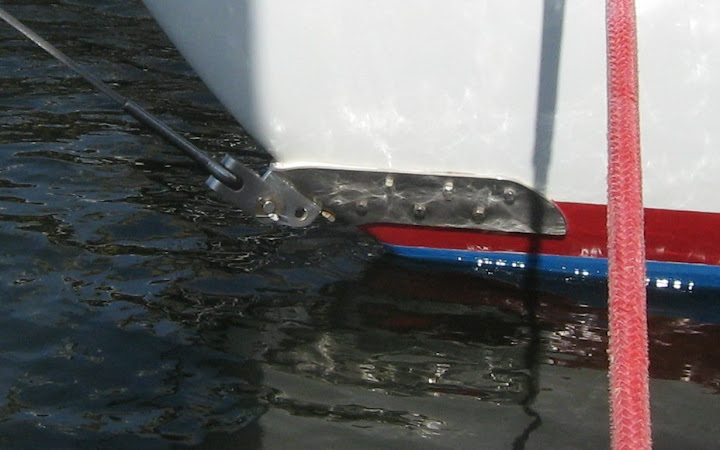

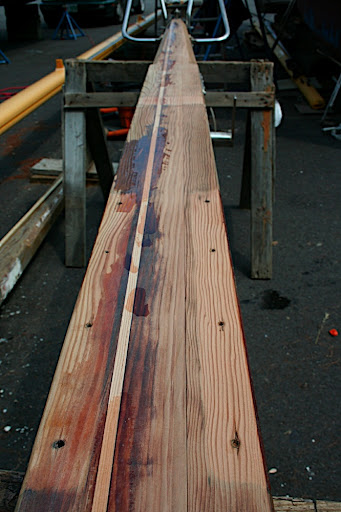

Making a casting pattern for the bobstay. I’ve decided to go back to bronze plates on either side of the hull running parallel to the direction of the bobstay. It seems the most logical to me and to other people I’ve spoken to. I’m going to have a machine shop cut and bend the bronze for me. Not wasting any more time trying to DIY. Rosie came up to help me engineer and measure for these pieces. We mocked up a bowsprit, to get the proper angle of pull, and took some measurements with a digital level for angles etc. He is drawing up a schematic to give to the machine shop.

Varnish

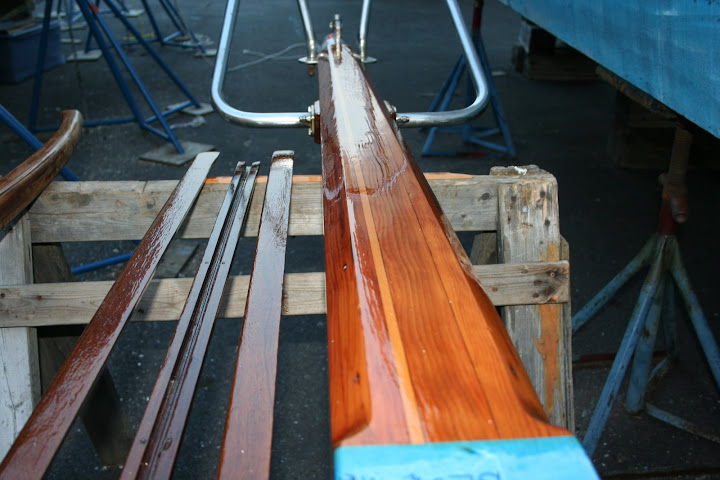

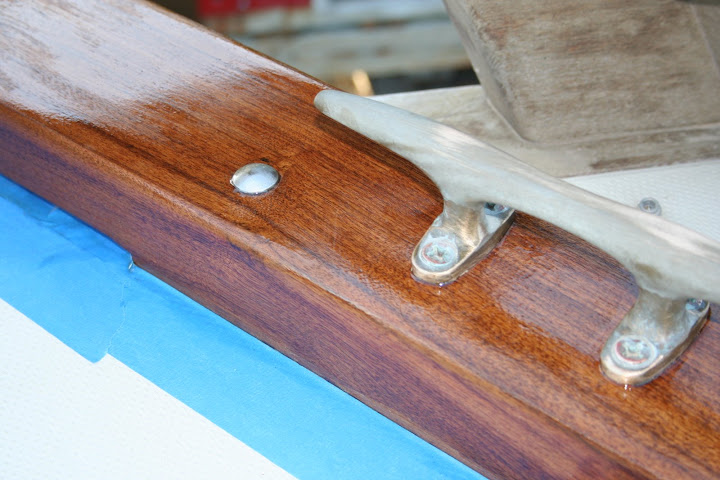

I have few varnish projects going on, little by little I’m building up coats. Epifanes is going on nicely. I use penetrol and thinner to keep it flowing, and lay it down. I worked with a Jamacian guy at G&B last year, who would always tell my “more tinnah mon, it need more tinnah.” I will be switching over to Honey Teak on a few pieces, for comparison of longevity.

Bottom Prep

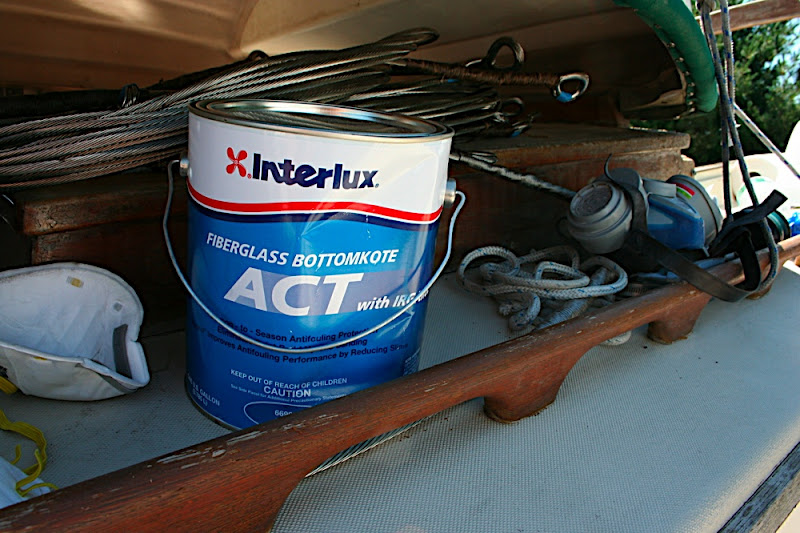

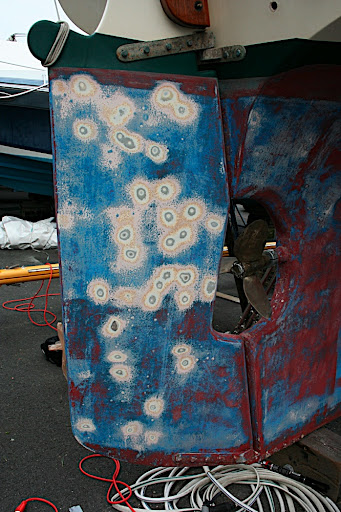

Both sides of the hull are sanded and barnacles scraped. A Few spots of epoxy applied to the barrier coat as needed. I’m not sure what paint is on there now, nor what I’m going to put on. Zincs are installed.

Tiller Rot & Delamination

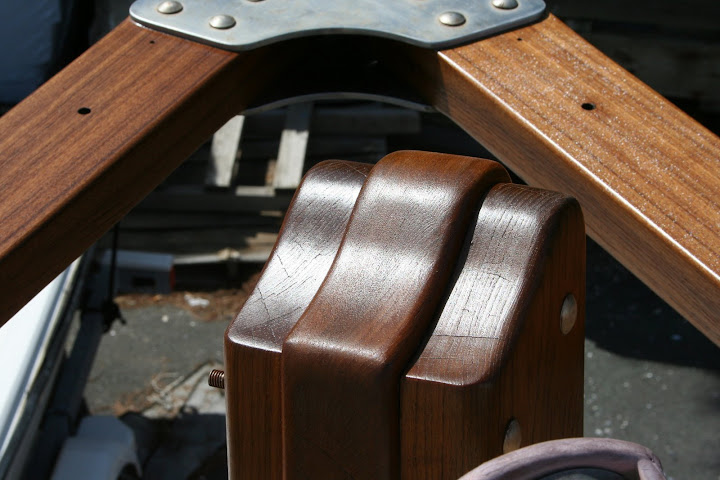

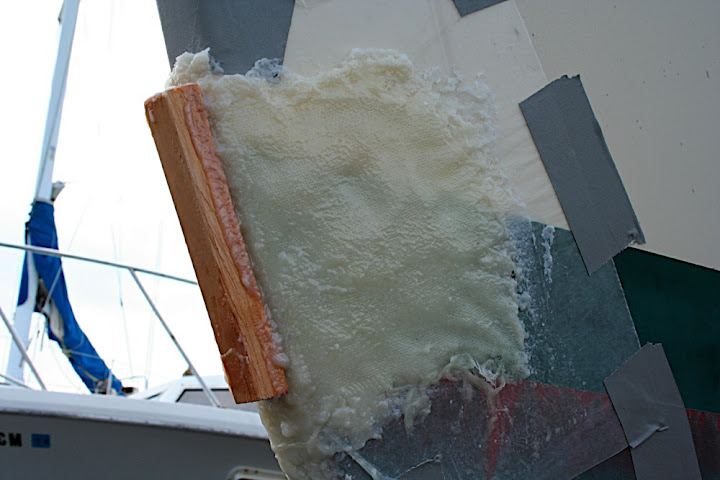

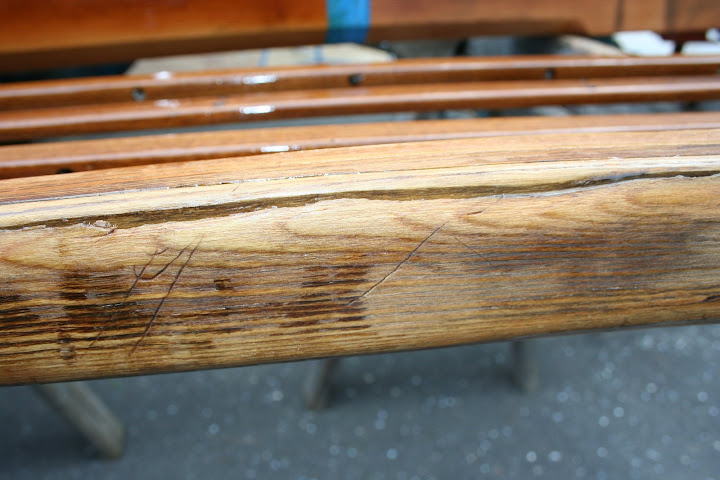

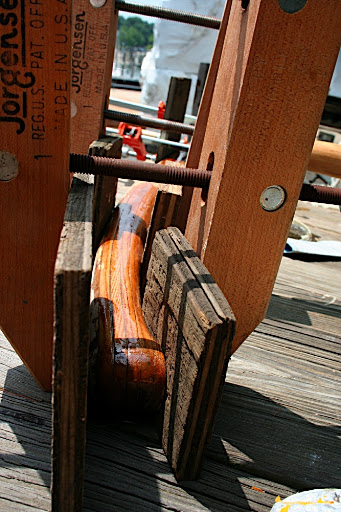

The tiller is a mess. I’m probably wasting time trying to get this one back to a reliable state, that I can use this summer/fall. I’ll build a new one this winter. I discovered a bunch of dry rot. I CPES-ed it, and have been filling the gaps with epoxy to try to re-glue it. Most of the glue joints are fine, but like the bowsprit, the UV damaged the glue, and the exposed edges of the joints are shot.

Mast Corrosion
The Forespar mast was bought new in 1999 by Steven. It, like most everything on this boat is unused, ie, never been sailed. However, being in TX has accelerated the decay processes. The mast is bubbled all over. Rosie brought up a good point the other day - The sail track is bubbled and the sail probably wont raise! So add that to the list. I’m planning to touch up the mast as needed for now, see how that goes, then at some point in the future either replace the whole mast or repaint it. Tef-Gel, UVHM tape and Lanolin are on their way… I’ll rebed as much hardware as I can.

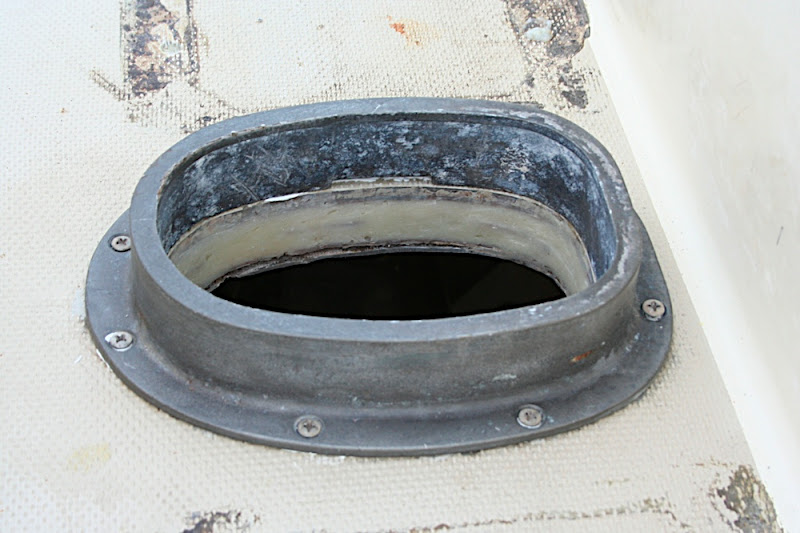

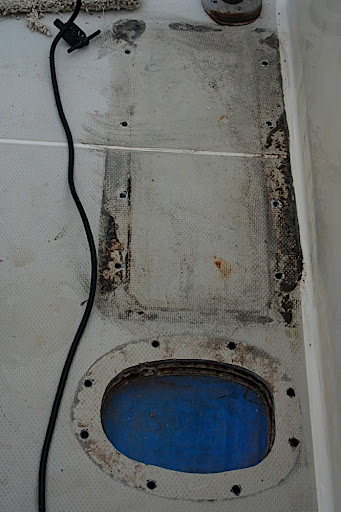

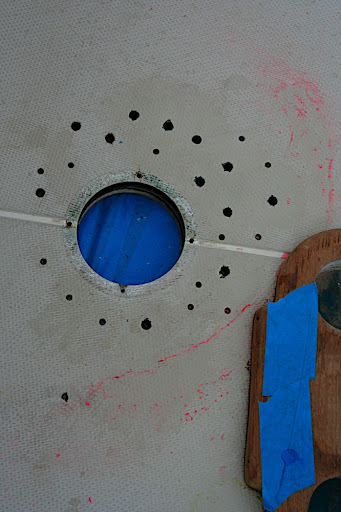

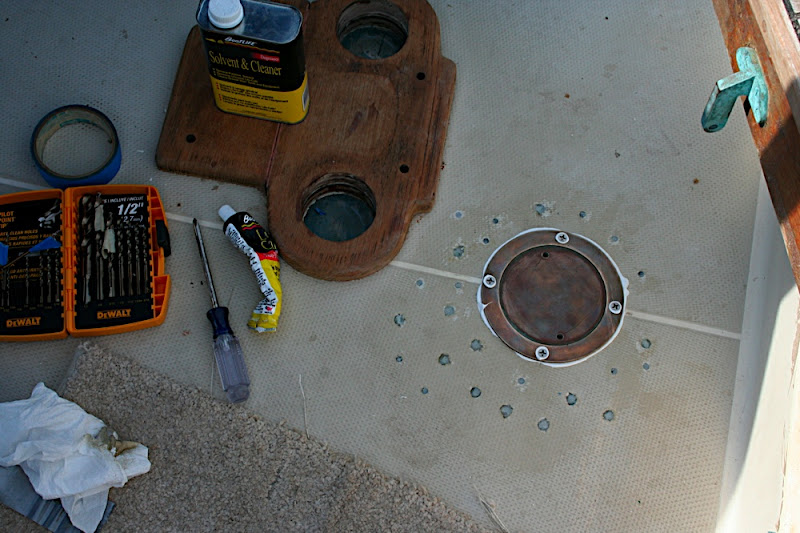

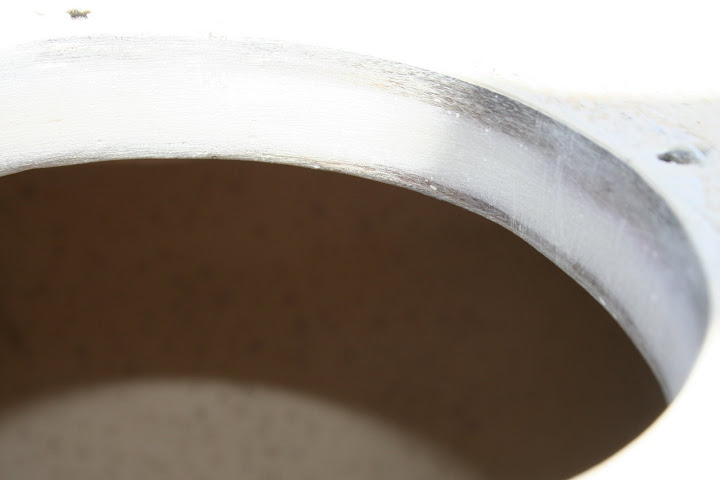

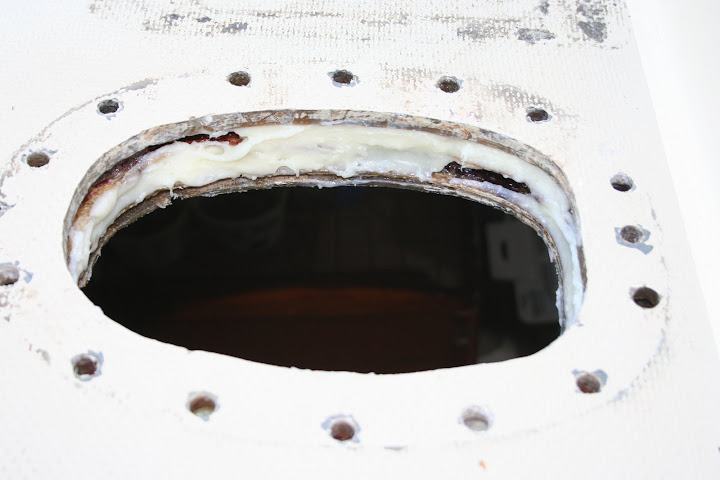

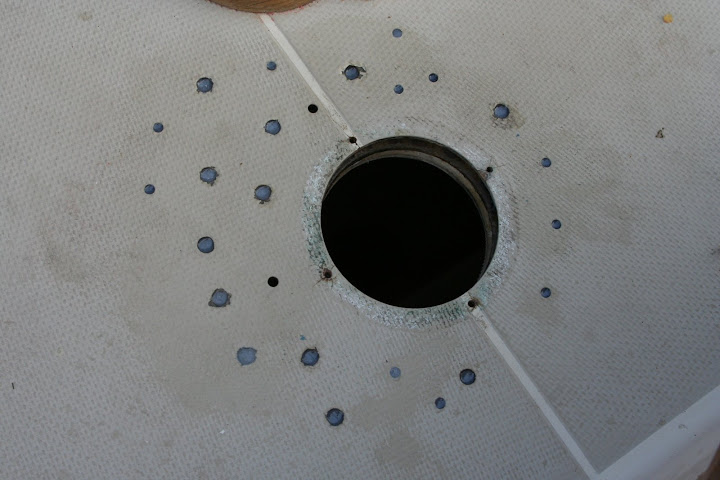

Deck Core

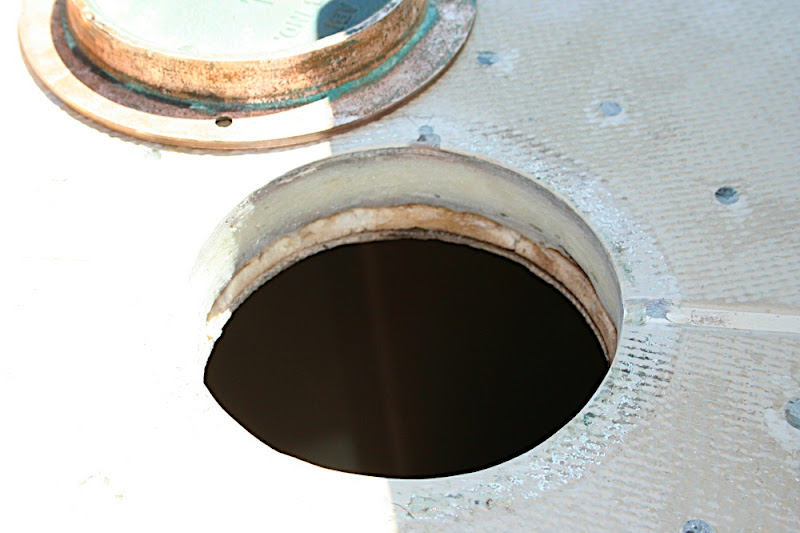

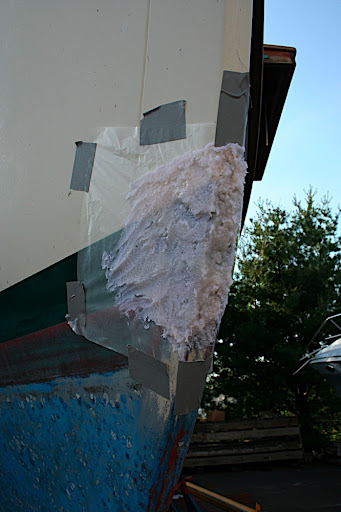

I’m finaly getting to fill in the exposed deck core with epoxy. I wanted the CPES to have plenty of time to dry out and the solvents to evaporate. Of course, after I applied the CPES the first time, it rained. So I built a temporary cover for the bow of the boat, drilled out the water-logged CPES, let it dry, and applied it again. It’s been along process. Filling in the cavities is a multi-step process. I want to ensure I don’t have any air voids.

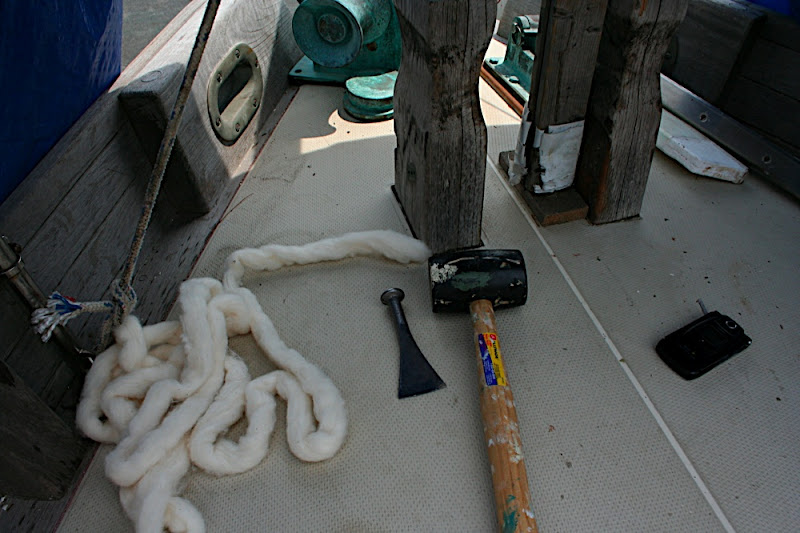

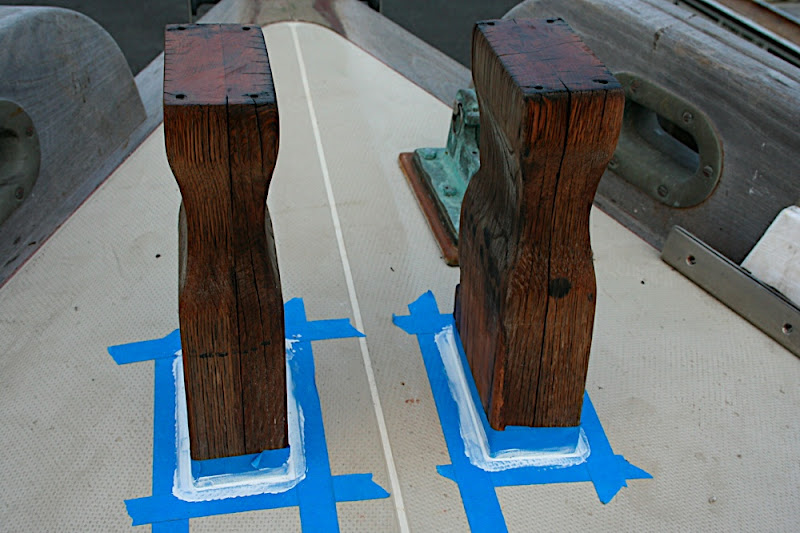

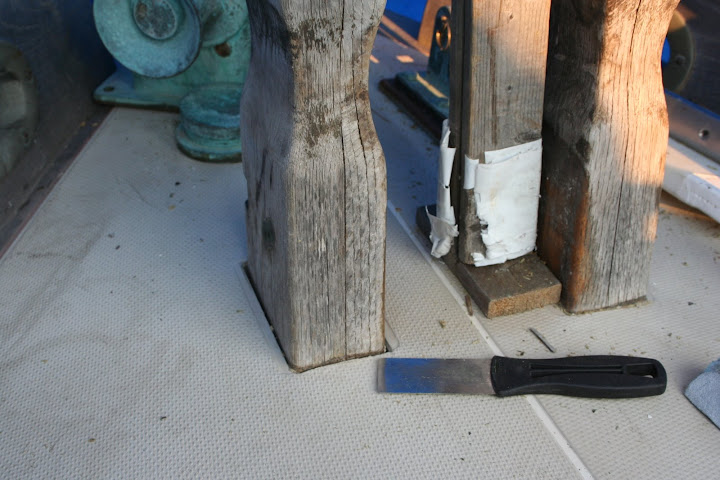

Caulking Sampson Posts

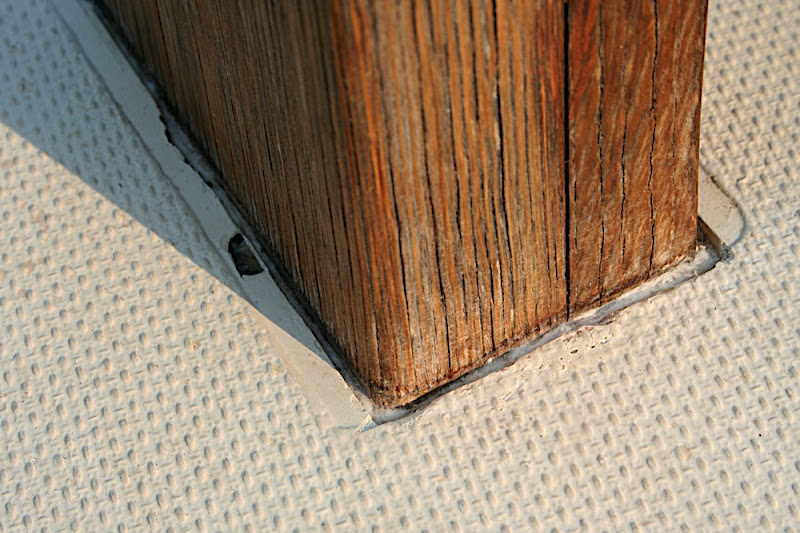

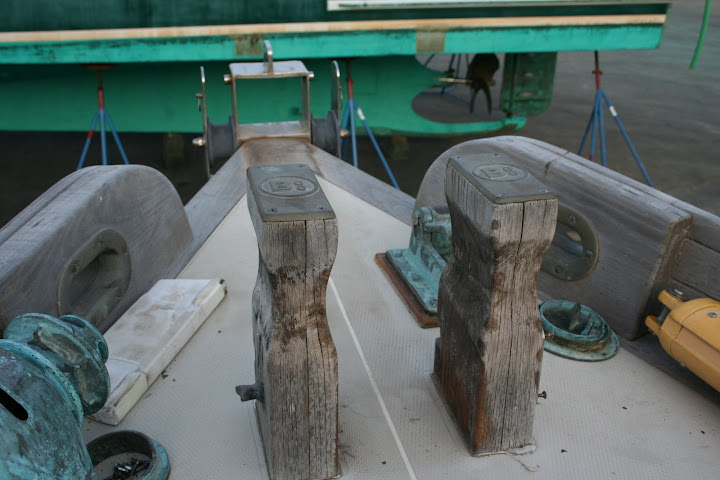

While the bowsprit is off, I’m caulking the sampson posts. I grabbed some cotton from Myles, and ordered a caulking iron. I’ll top it off with some polysulfide.

The Scene

My friend Marc is coming up for a few days to lend a hand, but there’s no room at the Inn, I suppose we’ll have to sleep on deck. Sterling arrived. I hope I bought enough. It sure isn’t cheap.
